Home
Capacity Workload
Nov 9 – Nov 15
Capacity153
Workload212
Days available-59

ShotGrid resource planning

Autodesk · Principal Experience Designer

Overview

I was Principal Experience Designer for Shotgun Software (later rebranded to ShotGrid) at Autodesk.

ShotGrid is Autodesk's award-winning production and collaboration platform used by the world's best creative studios to create film, TV and games.

The Resource Planning project was the work of a team focused on helping our clients to:

"Maximise understanding of artist utilisation in their studio, so that they can minimise artist idle time & overbooking"

Outcome

Customer satisfaction in target enterprise studios increased

My responsibilities

Data visualisation, Defining 'Jobs to be Done', Design system components, Facilitating workshops, Interaction design, Prototyping, User research, User story mapping

Other team members

1 Product Manager, 4 Engineers, 1 QA

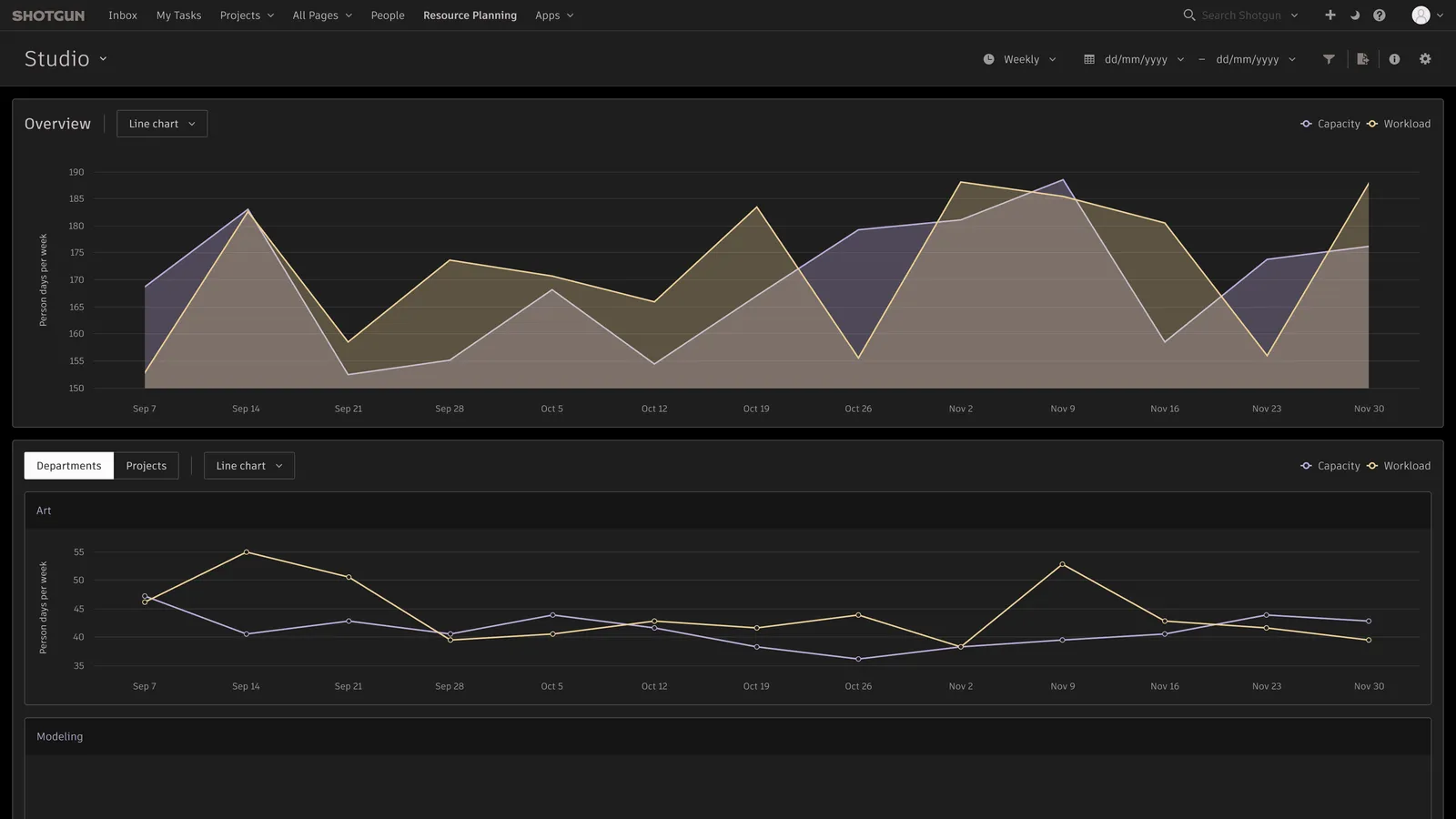

Resource Planning studio overview — Dark
Resource Planning studio overview — Light
Light Dark

It is super clear - the graphs are really helpful.

— Brown Bag

It's really cool. I have NO way of seeing this data at the moment, in such a simplified way.

— Method

I'd love this, very helpful I think.

— Netflix

Discovering opportunities

We were given a directive to focus on improving the experience for enterprise clients and so we started by surveying 50+ studios to uncover their unmet/underserved needs. We used a method based on Outcome-Driven Innovation (ODI) to measure satisfaction vs. importance.

We then held a summit with 36 attendees from 20 studios to gather context for the survey results in the form of qualitative feedback. We also used the summit as an opportunity to test some early concepts and get our clients involved in participatory design exercises.

Summit attendees in discussion
Participatory design workshop at the summit

Defining and scoping the problem

We went into a lot of detail studying Resource Planning workflows and understanding key Jobs to be Done, to develop a story map for an MVP.

Resource Planning workflow and story map

Ideation and exploration

Using the inspiration from customer research, we explored a variety of ideas focused on helping studios gain better insights into Capacity and Workload.

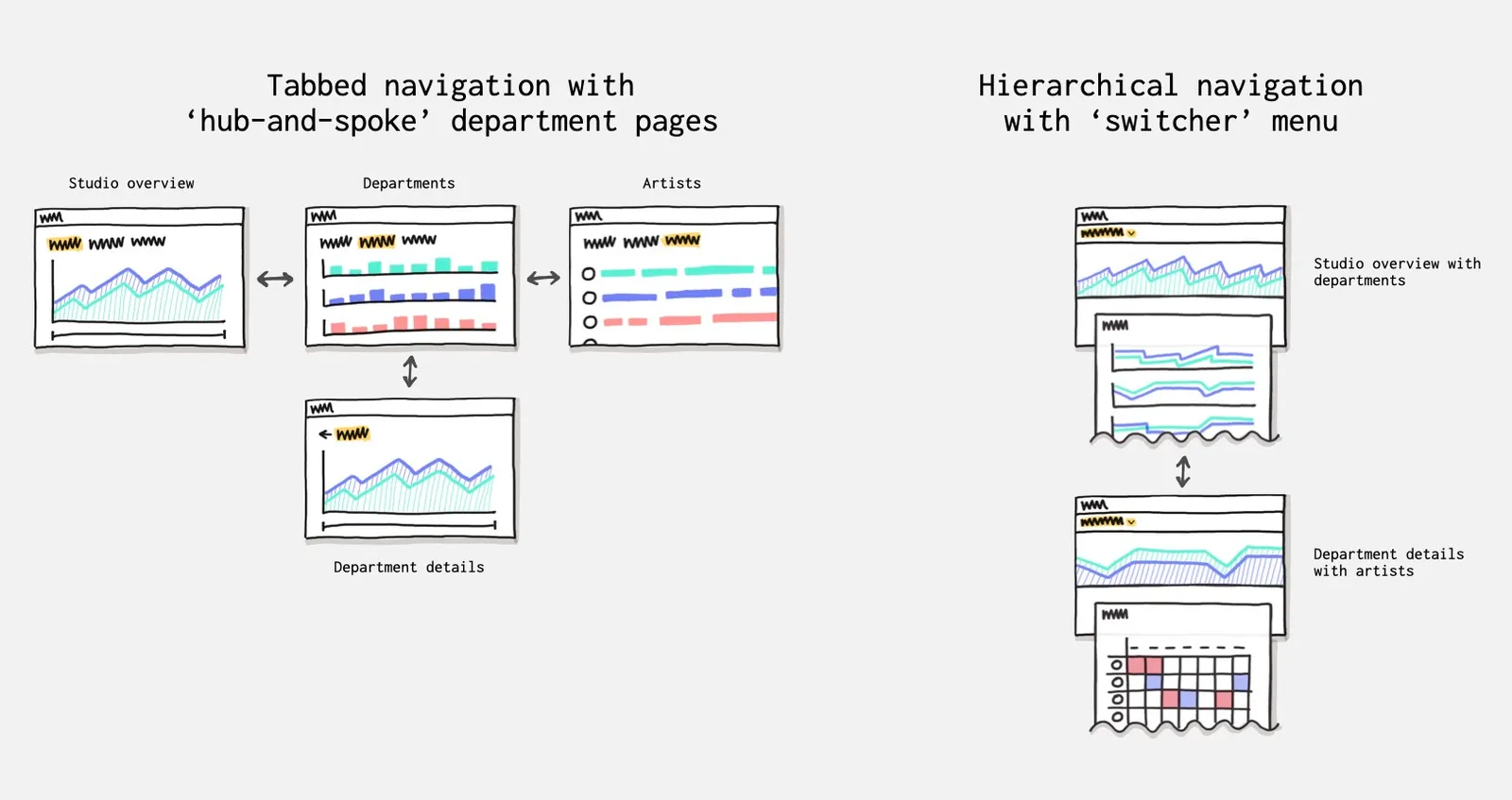

Navigation explorations — tabbed vs hierarchical

Early concept explorations

Creating a roadmap

We created a roadmap that showed how Shotgun’s suite of scheduling tools would evolve from what they looked like at the start of the project, into the future vision/direction.

Scheduling tools roadmap — Future vision

Scheduling tools roadmap — Start of project
Start of project Future vision

Research using a reference customer program

In order to keep our clients engaged in the process, get regular feedback on our work-in-progress and collaborate with them on building the features, we setup a Reference Customer Program (RCP) with target clients from the VFX, Animation and Games industries, including:

Image Engine, Method, DNEG, Netflix, Brown Bag, Mikros (Technicolor), Rodeo, Industrial Light & Magic, Framestore, Animal Logic, and Massive

The RCP evolved over time through various stages to meet the needs of the project, these included:

  1. Requirements gathering
  2. Concept testing
  3. Prototype testing
  4. Beta testing
Reference customer program sessions

Reference customer program collaboration board

Principles

A set of three straightforward design principles helped us make decisions during the project

Accurate: We use data visualization best practices and aggregate data in the right way, revealing exact data points when required

Actionable: We support key workflows, and minimise context-switching

Trusted: We communicate how aggregates are calculated and allow for customising calculations (when appropriate)

Design overview

The goal of Resource Planning is to:

Maximize understanding of artist utilization in your studio, so that you minimize artist idle time & overbooking

It provides the capabilities to do this using three main views: Studio Overview, Department Details and Project Details.

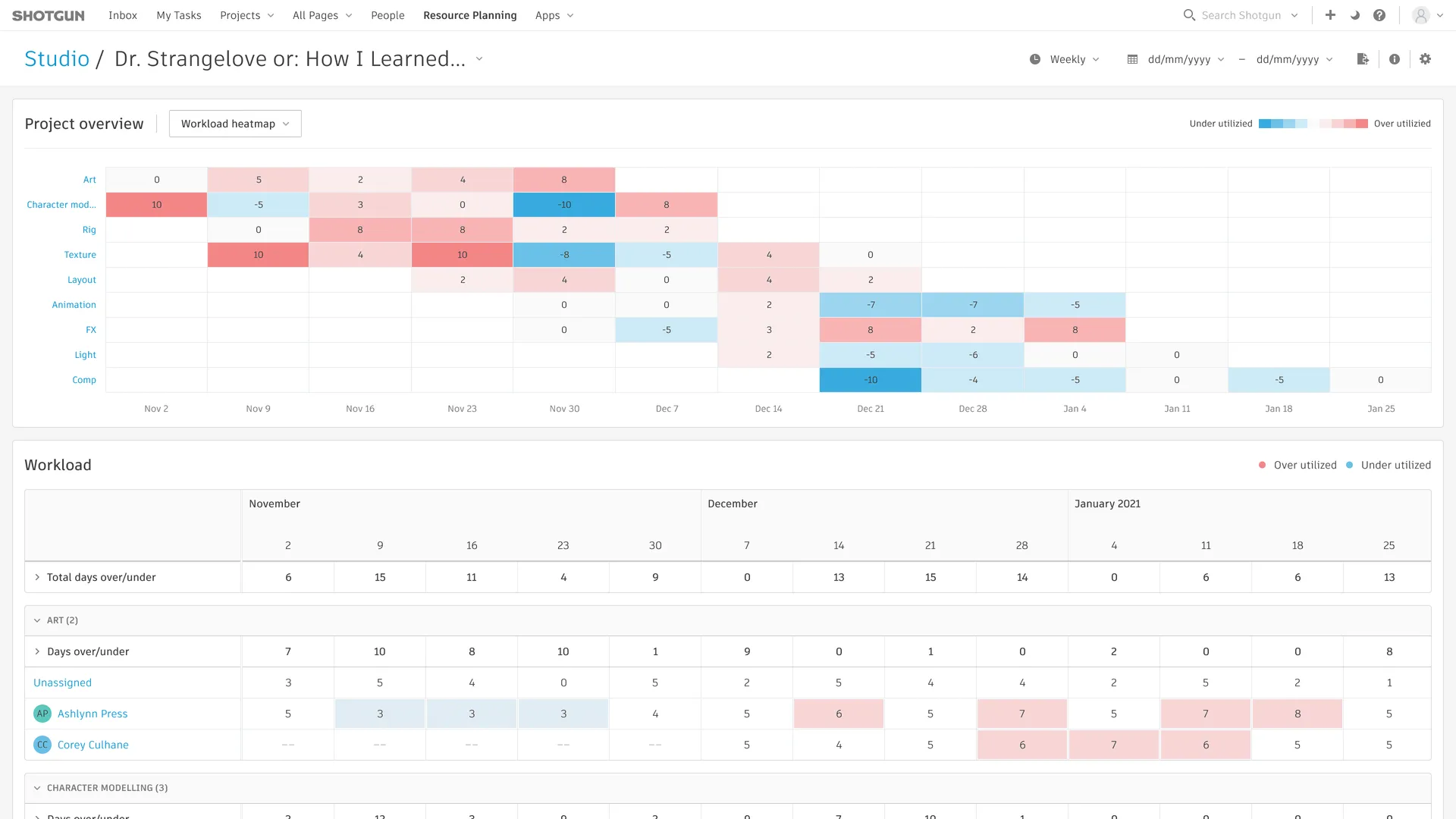

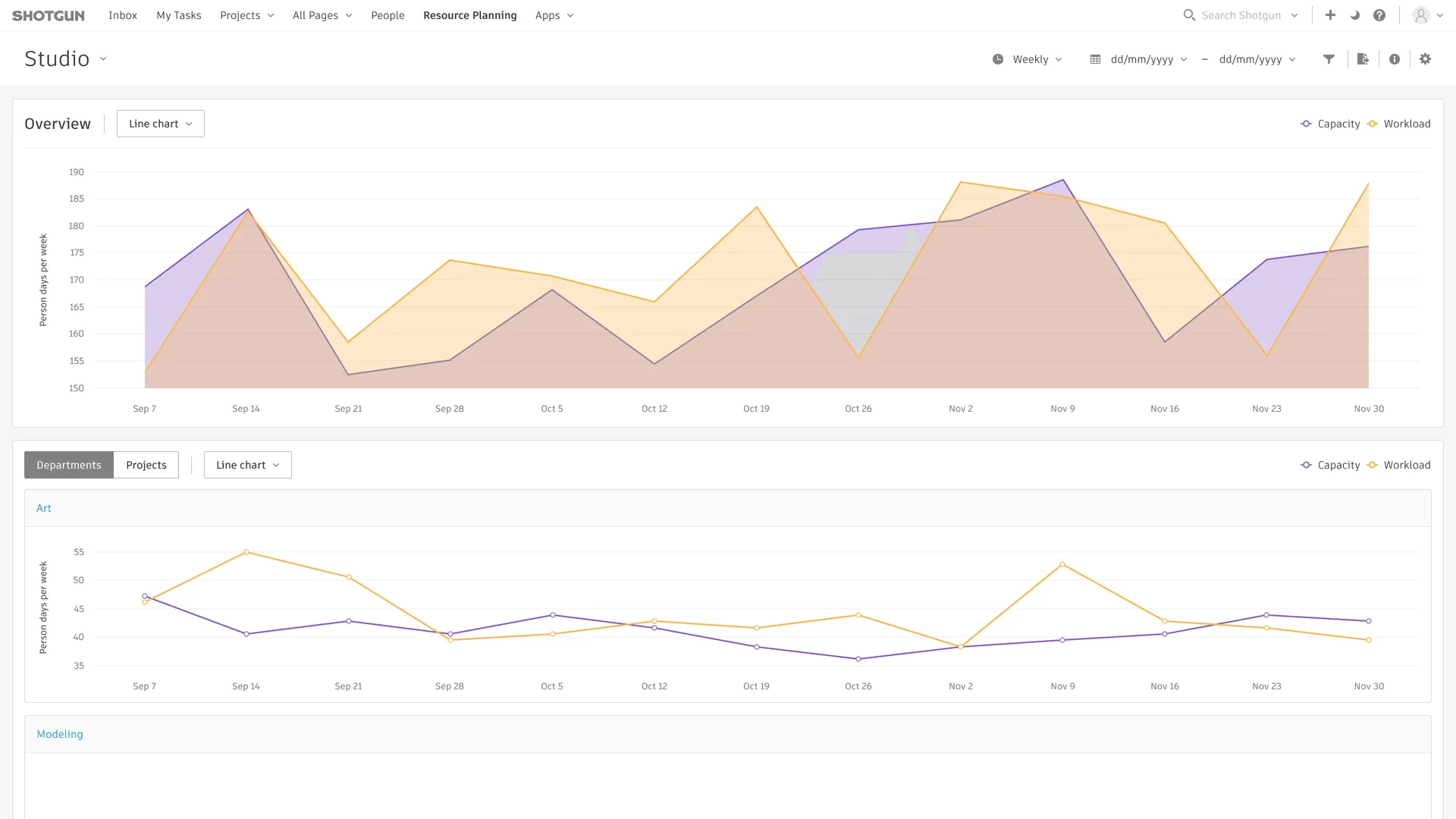

  • Studio Overview: provides a studio-wide overview of capacity and workload, with breakdowns of individual departments and projects

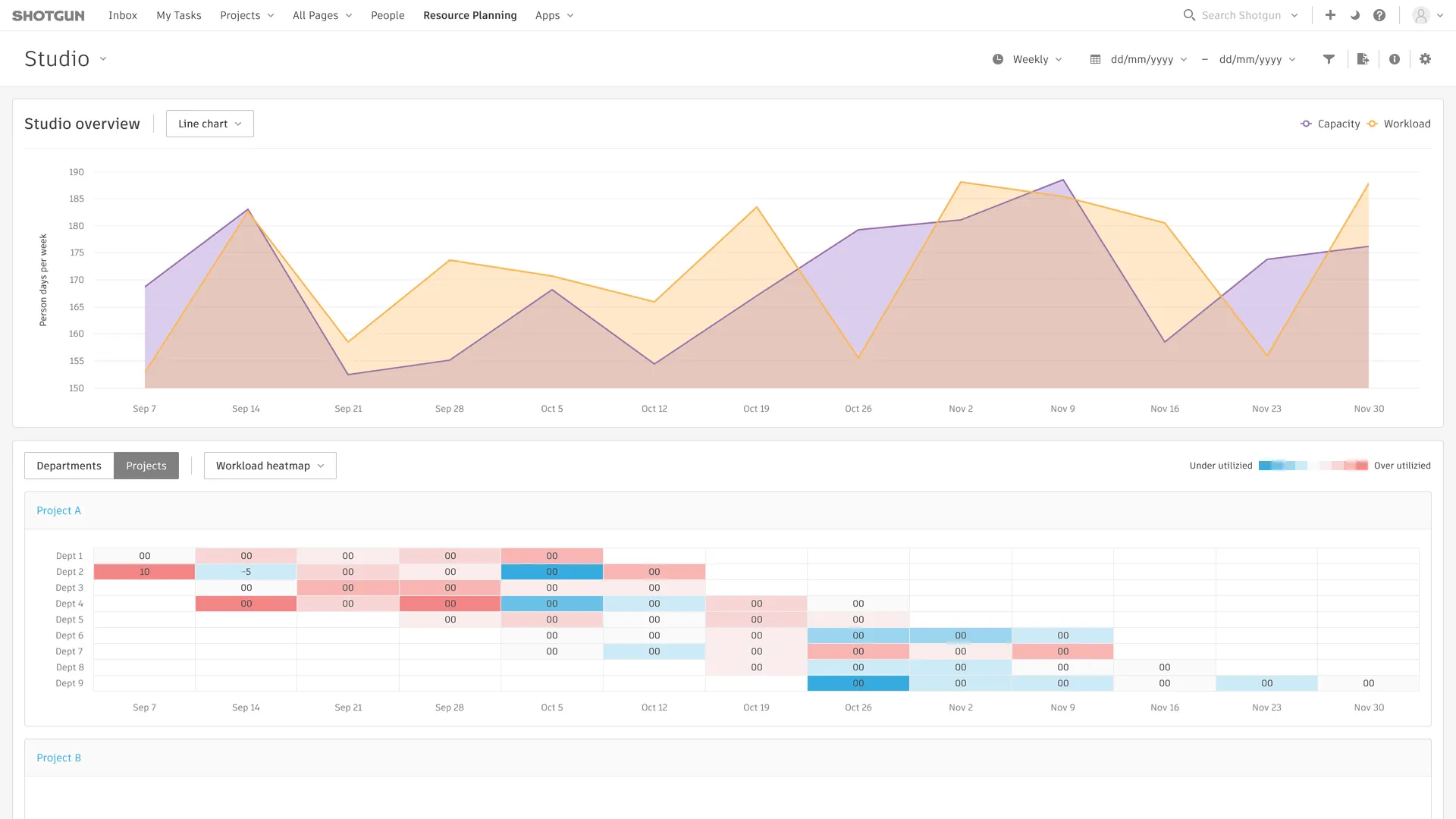

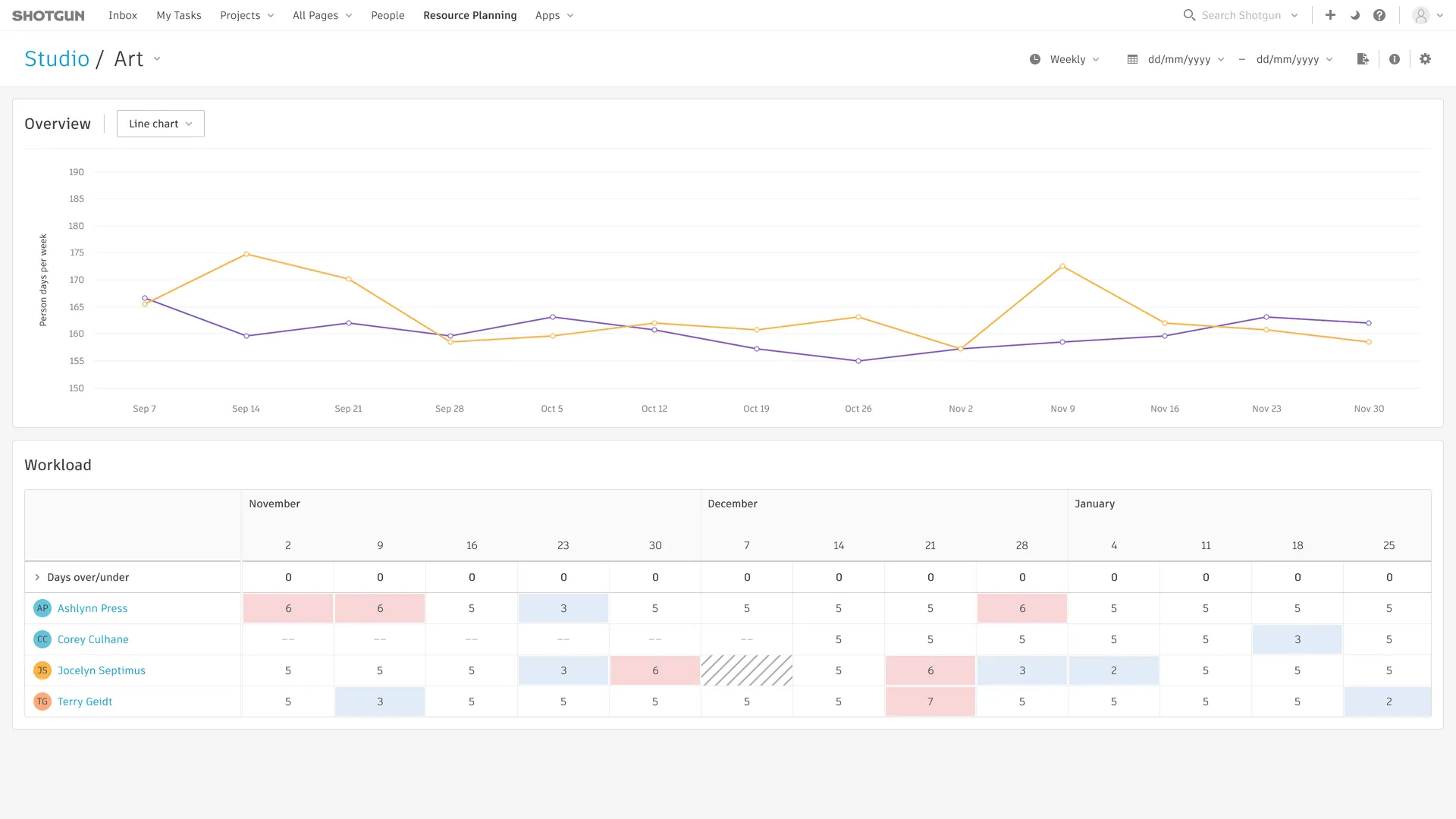

  • Department Details: displays an aggregate of capacity and workload for the department, with details of the workload of each artist in the department
  • Project Details: displays an aggregate of capacity and workload for the department, with details of the workload of each artist assigned to the project grouped by department

Design details

Flexible navigation

Some of our clients have a lot of departments and projects, so it was important to develop navigation that would support this. The menu at the top of the screen allows for quickly browsing both departments and projects in a hierarchical structure, but when a search term in entered the hierarchy is flattened and all search results are presented in a single categorised result set.

In addition, whenever data is presented about a department or project, entry points to the detail page for the respective department or project are also provided.

Adaptable controls

A combination of a segmented control for navigating between departments and projects, together with a dropdown menu for changing chart types, provided a flexible and future-proof way to allow the number of chart types to expand in the future, without the need to change the page design.

Designed for forward journeys

Examining the data often leads to users wanting to dive deeper or perform an action in relation to the data. To aid with this, we focused on facilitating some key actions that we identified:

  • Pulling work forward / pushing work back
  • Reassigning tasks
  • Checking project milestones

Where possible we kept key actions in-context to minimise users having to re-orient themselves on a new screen.

Outcomes

Resource Planning launched in September 2021. It generated a lot of excitement and positive feedback from our clients:

It is super clear - the graphs are really helpful.

— Brown Bag

It's really cool. I have NO way of seeing this data at the moment, in such a simplified way.

— Method

I'd love this, very helpful I think.

— Netflix
